Construction at the Ust-Luga Sea Port progress report as per the end of 2019
Customer: JSC “Company Ust-Luga”.
Construction investor: Novotrans Group of Companies
Construction period: April–December, 2019

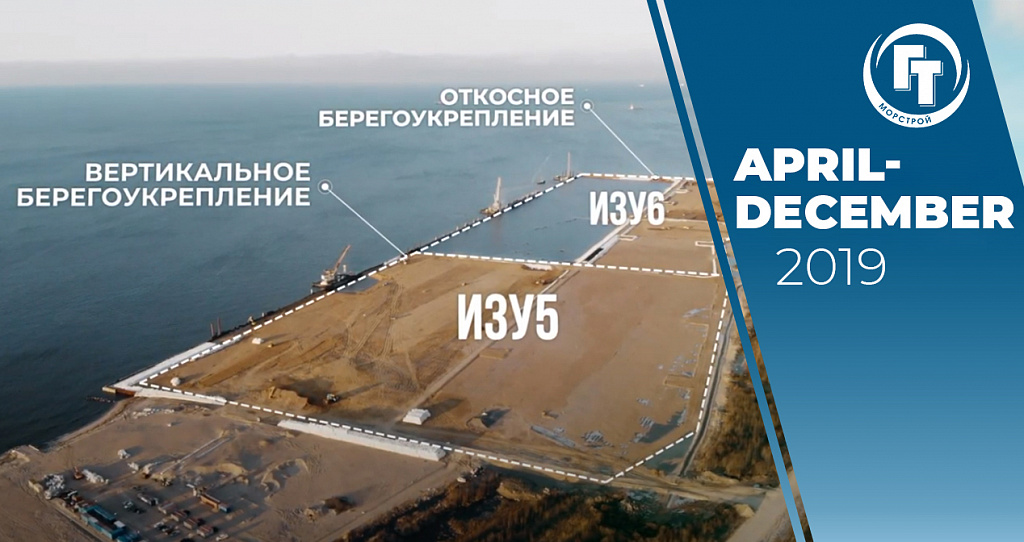

Summing up the results of 2019, we would like to inform you about construction progress at the Ust-Luga Sea Port within the “Artificial Land Plots for Construction of Sea Terminals of the 5th and 6th Stages of General Cargo Complexes in the Ust-Luga Sea Port” facility:
- production of sand geotextiles sacks – 62,367 pcs;
- pile shells driving – 813 pcs; pipe pile – 32 pcs; sheet pile L5-UM – 2,642 pcs;
- diking dams sand dumping – 259,200 m3;
- sloping bank protection – 23,810 m3. of stone and crushed stone;
- territory development using sand – 1,030,000 m3
See video of construction at the Ust-Luga Sea Port progress report
