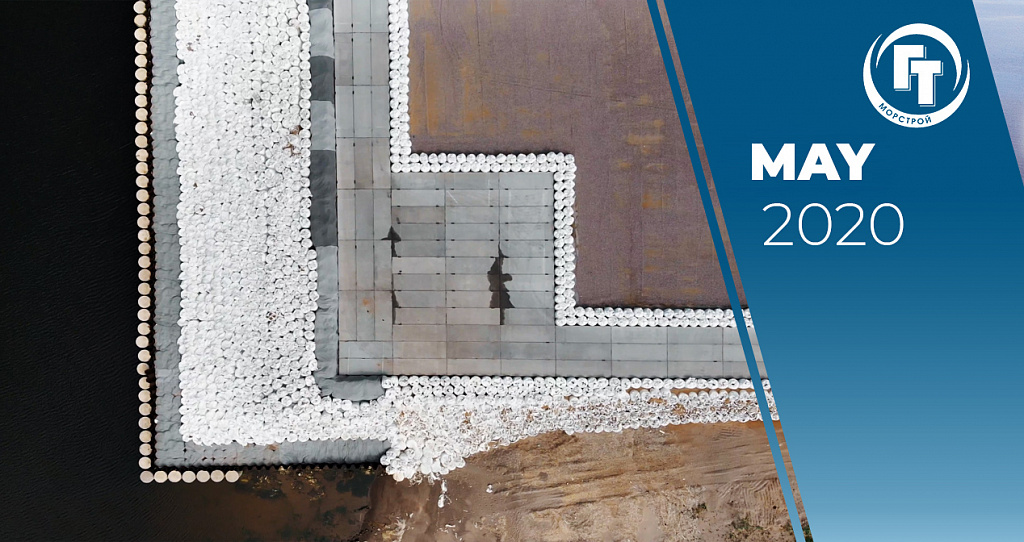

Construction at the Ust-Luga Sea Port progress report. Period: May, 2020

Customer: JSC “Company Ust-Luga”

Construction investor: Novotrans Group of Companies

Construction period: May, 2020

Facility: “Artificial Land Plots for Construction of Sea Terminals of the 5th and 6th Stages of General Cargo Complexes in the Ust-Luga Sea Port”.

Final work at the facility was carried out:

  • Work on securing of ALP cells of 5th and 6th stages using crushed stone has been completed: 1,911 cu m
  • Territory development using sand has been completed: 66,385.5 cu m
  • Construction of passage in quay apron is completed with pavement made from PAG slabs: 6096 sq. m.
  • Placement of sand geomats has been completed: 22,387 cu m

At the moment preparation of documentation for obtaining of Finding of Compliance (FOC) and Finding of Environmental Supervision (FES) is underway.
