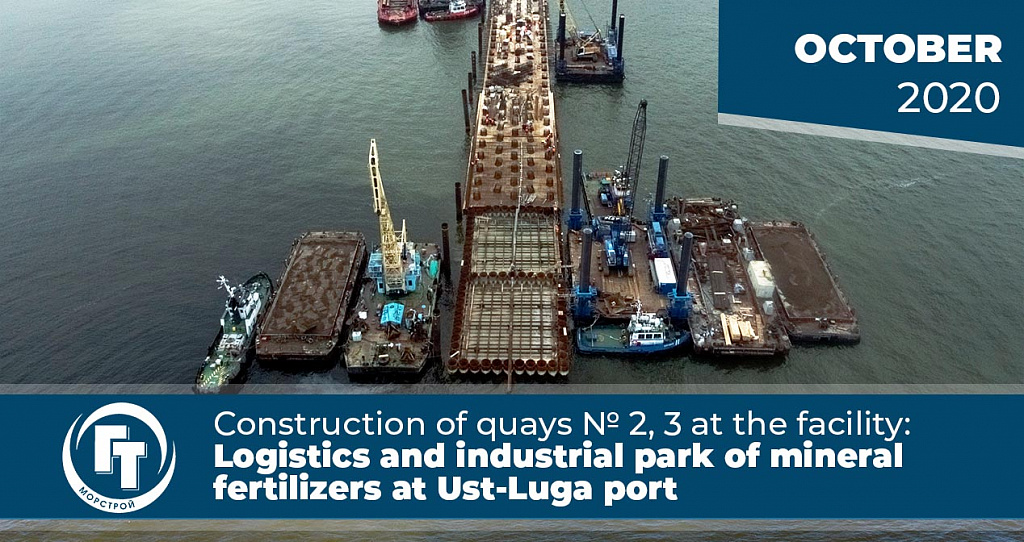

Construction of quays № 2, 3 at the facility: Logistics and industrial park of mineral fertilizers at Ust-Luga port

Customer: Ultramar LLC

Period: October 2020

Facility: "Range of works on construction of quays № 2, 3 at the facility: Logistics and industrial park (complex) for storage and transshipment of mineral fertilizers with storage facilities and rail infrastructure at the municipal settlement “Vistino village settlement” of the municipal entity Kingisepp municipal district of the Leningrad Region. Marine shipment terminal"

- October saw the last hollow shell piles sinking:

• Sinking hollow shell piles, 1420х18 mm in diameter, 38.8 m long. - 1 pc (24.9 tons);

• Sinking hollow shell piles, 1420х18 mm in diameter, 40.2 m long. - 12 pcs (307.49 tons);

• Sinking hollow shell piles, 1420х18 mm in diameter, 43.3 m long. - 41 pcs (1050.83 tons).


- Filling up the hollow shell pile cavities (144 pcs):

• with sand (from -17.2m to -3m) – 2039.4 cubic m.

• with concrete (from -3m to -2.5m) – 71.2 cubic m.

• with concrete (from -2.5m to +1.5m) – 880.7 cubic m.


- Filling up the cavities of the face wall’s tongue-and-groove tubular fabricated section (60 pcs):

• with sand (from -17.2m to -3m) – 1503.3 cubic m.

• with sand (from -34m to -0.5m) - 230 cubic m.

• with concrete (from -2.5m to +0.9m) – 308.3 cubic m.

• with concrete (from -0.5m to +1.5m) – 27.2 cubic m.


- Fabricating and installing reinforcing cages - 144 pcs. (230 tons.)


- Fabricating and installing fasteners for hollow shell piles - 373,077 tons.




See video of construction progress
